J Gunn Scaffolding was proud to work on the restoration of Scarborough Train Station and Clock Tower. Let’s have a closer look at the project.
A classic Victorian station
Scarborough Train Station first opened on 7 July 1845, serving as the terminus of the line from York. The design was by notable railway architect George Townsend Andrews, one of the most significant names in early Victorian railway architecture.
The station originally had a large booking hall, waiting rooms for various classes, toilets, porters’ rooms, and a refreshment room. It had two platforms at first, connected at the north end, with four tracks and turntables between them.
There was a significant expansion of the station in the late 19th century; as seaside tourism grew, the station had to expand so it could cope with rising passenger numbers. It got two new platforms (now Platforms 1 and 2) with additional waiting rooms and amenities in 1883.
Restoration
Scarborough Train Station is a Grade II building, obtaining the status on 8 June 1973 in recognition of its architectural and historical importance. However, as part of Network Rail’s newest restoration project, it would receive new upgrades. They would take place in two phases.
Network Rail asked several of their preferred suppliers to submit competitive quotations for the complex restoration works, including a large amount of scaffolding. Colt Construction was successful in winning the contract.
The scaffolding was designed by RV Engineering, a specialist who works closely with Colt and Network Rail. J Gunn Scaffolding was chosen as the preferred scaffolding supplier because we have a vast amount of experience and knowledge of train station working environments. Crucially, we’ve had the pleasure to work with Colt on several other key projects.
The station
The first part of the project was work on the platforms. RV Engineering had to begin by designing a scaffolding crash deck. However, as well as facilitating the restoration work, it had to ensure the station
operations would be able to continue, supporting staff, p
assenger’s, and the public.

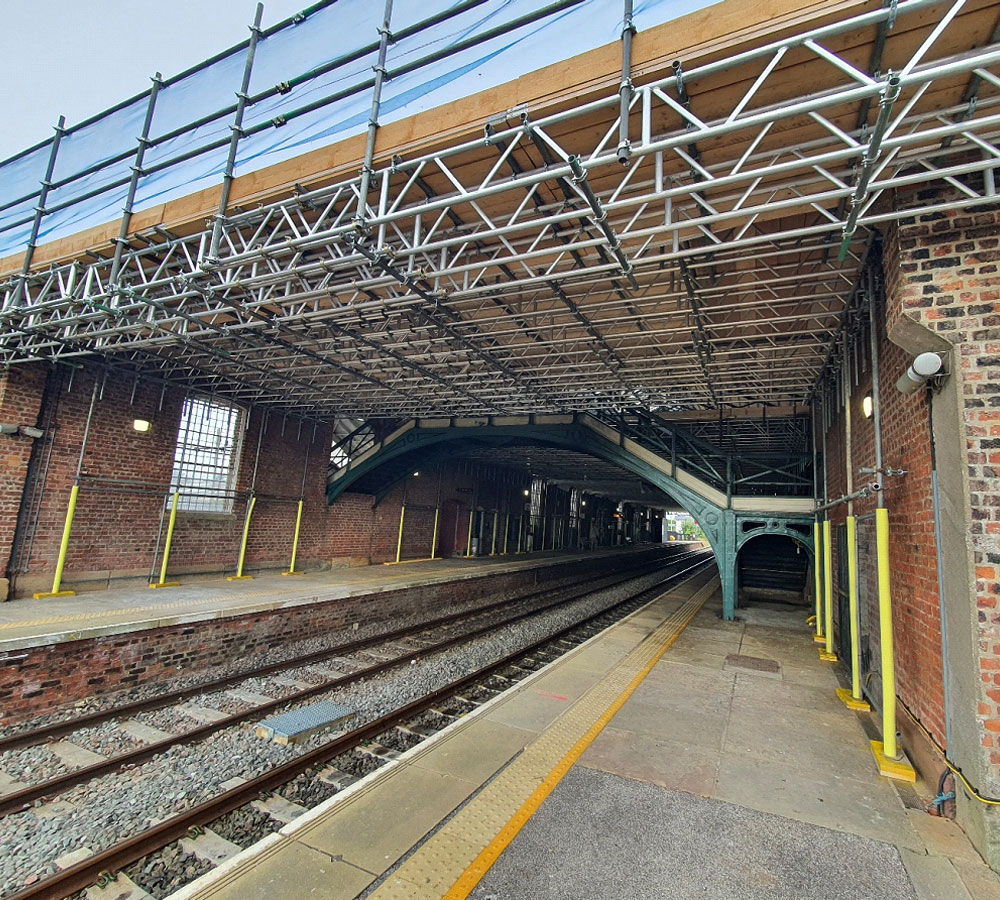

The scaffolding crash deck was designed to cover the full concourse of the station’s platforms. As a result, it had to include ventilation for the trains. Additionally, it had to include fire protection, so below the crash deck had to feature a fire blanket.
The scaffolding work began in 2021 with the construction of large numbers of support towers on each platform to take the weights of the unit beams holding up the crash deck. The towers’ design also had to ensure they did not affect the sight of the train drivers when entering or leaving the station.

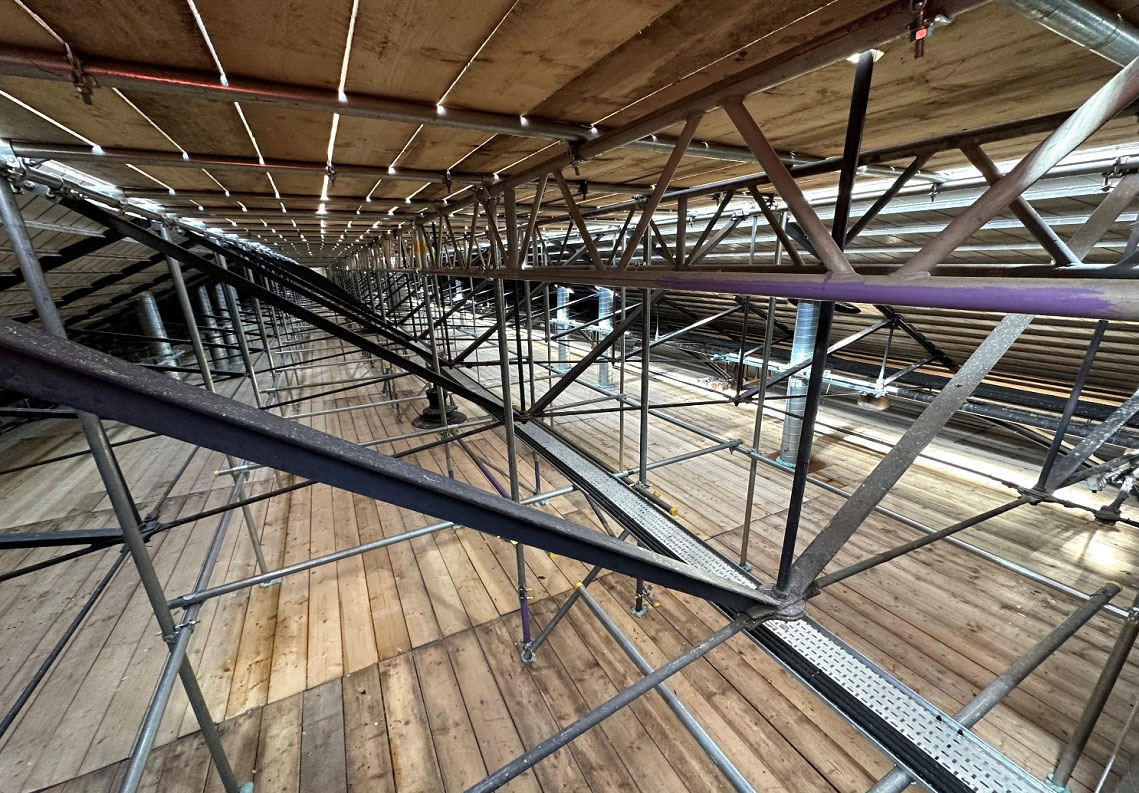

Once the crash deck frame was built, the area was double boarded and sheeted with FR rated materials to prevent dust or other loose debris falling.
Above the crash deck were two additional independent towers to allow safe access to the taller areas of the roof. This was necessary to allow removal of the glass panels and replacement with slate.
The clock tower
Scarborough Train Station’s clock tower was an addition in the 1880s, around 1882 to 1884, as part of the expansion. It has an elaborate Baroque style with a lead dome, making it more decorative than the classic pavilions of the original building. The clock tower contrasts with the rest of the station’s Italianate architecture, adding vertical emphasis and a sense of grandeur to the central pavilion.
The second part of the restoration work was to repair stonework on the clock tower. Completing this job would require another complex piece of scaffolding to allow stonemasons to work safely on all levels simultaneously. Once again RV Engineering did the design.
The complex clock tower scaffolding had four support towers and 750-unit beams spanning above and around the structure to allow access to all areas. Additionally, the scaffold punched up, introducing 450 unit beams for weight distribution.
Like the work on the platforms, the scaffolding for the clock tower also had to ensure that the train station could operate as usual, ensuring no harm to passages, staff, and the public.
A successful scaffolding project
We’re incredibly proud to say we were able to complete our work here safely, on time, and within budget.
If you’d like
to find out more or have another project to discuss with us, please get in to
uch.
